Data Fields

The Gantt Chart is driven entirely by the fields you drag into its wells. This page explains every field: what it does, whether it's required, how many columns it accepts, and how to shape your data for it.

Only three fields are requiredCategory, Start date, and End date. Everything else is optional and can be added in any combination.

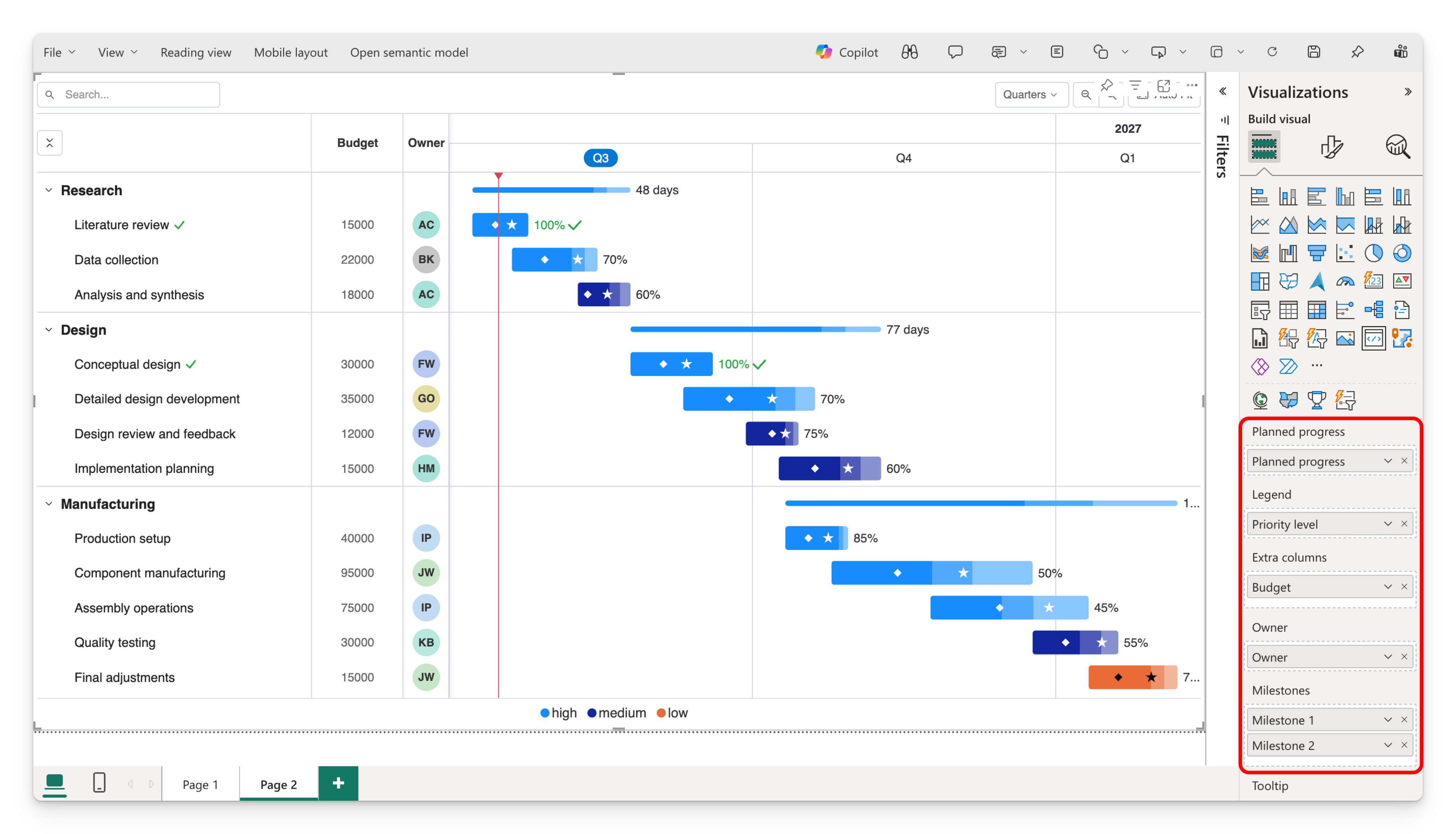

The full Build/Fields pane for the Gantt Chart with every field well labelled and a few populated

Field summary

FieldRequired?Max columnsPurpose
Category✅ Yes10Task / sub-task hierarchy
Start date✅ Yes1Task start
End date✅ Yes1Task end
Progress barNo1Actual % complete
Planned progressNo1Planned % complete
LegendNo1Color tasks by this field
Extra columnsNo3Extra data columns beside the task list
OwnerNo1Owner initials in a circle
Task milestonesNo5Date columns shown as markers
TooltipNo4Extra fields on hover
URLsNo3Links opened from the task list
Task IDNo1Unique task identifier
Predecessor IDNo1Tasks this task depends on

Category (the task hierarchy)

Required · up to 10 columns · grouping field

Category defines the rows of your chart and their nesting. Each column you add is one level of the hierarchy, from left (top level) to right (deepest level):

  • One column → a flat list of tasks.
  • Two columns → projects (level 1) with tasks nested underneath (level 2).
  • Up to ten columns → deep project → phase → task → sub-task structures.

Parent rows automatically become summary bars that span all of their children, and each parent can be expanded or collapsed in the task list.

ProjectTask
Website relaunchDiscovery
Website relaunchDesign
MarketingCampaign brief

In this example, "Website relaunch" and "Marketing" are top-level summary rows; the tasks nest beneath them.

tip

Order your Category columns from broadest to most specific. The first column is always the outermost group.

note

Parent rows roll up automatically — a parent's bar spans the earliest start and latest end of its children, and its progress is the rolled-up progress of those children.

Start date & End date

Required · 1 column each · measures

These set where each task bar begins and ends on the timeline. Both must be a Date or Date/Time type in your model. A task with a start but no end (or vice-versa) can't be drawn, so make sure every task row has both.

caution

If your dates arrive as text, convert them to a date type in Power Query or the model before assigning them here.

Progress bar

Optional · 1 column · measure · values 0–100

A measure representing how complete each task is, as a percentage from 0 to 100. The value fills the task bar so you can see progress at a glance. You can choose how the fill looks (a strip or an overlay) and whether the percentage is shown as a label — see Progress, colors & appearance.

Planned progress

Optional · 1 column · measure · values 0–100

A second percentage (0–100) representing where a task should be. When supplied alongside Progress bar, the chart can show planned vs. actual so you can spot tasks that are ahead of or behind plan.

Legend

Optional · 1 column · measure

The field used to color the task bars. For example, color by Status, Team, or Phase. When a Legend field is present, each distinct value gets its own color (which you can override), and a legend can be shown around the chart.

Extra columns

Optional · up to 3 columns · measures

Up to three additional data columns displayed between the task list and the timeline — useful for showing values like effort, budget, or a status code next to each task.

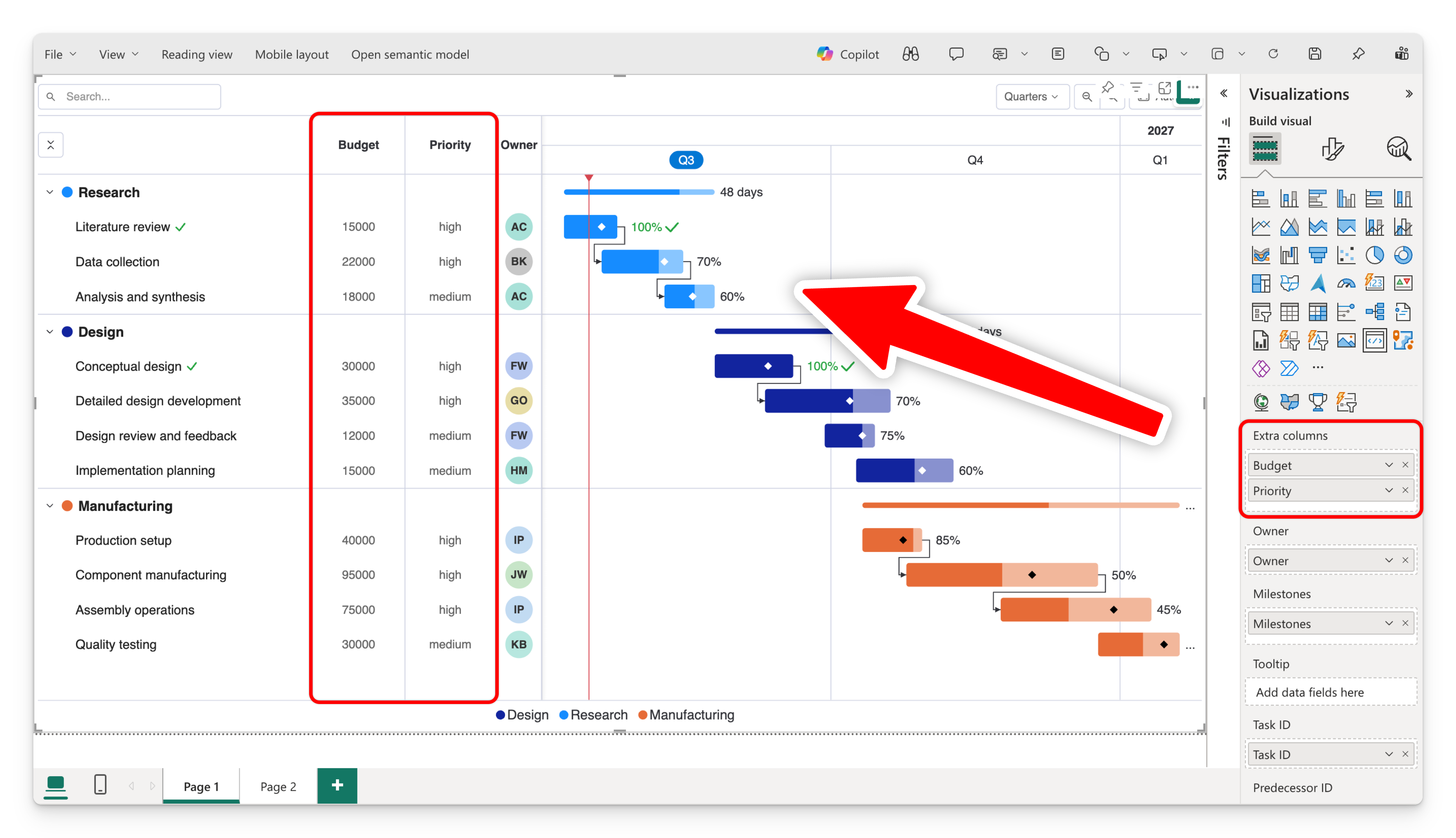

The area between the task list and timeline showing two extra columns of values aligned with their task rows

Owner

Optional · 1 column · measure

The task owner's name. The visual shows it as initials inside a colored circle on each row, with a consistent color per owner. Great for seeing who's responsible without widening the task list.

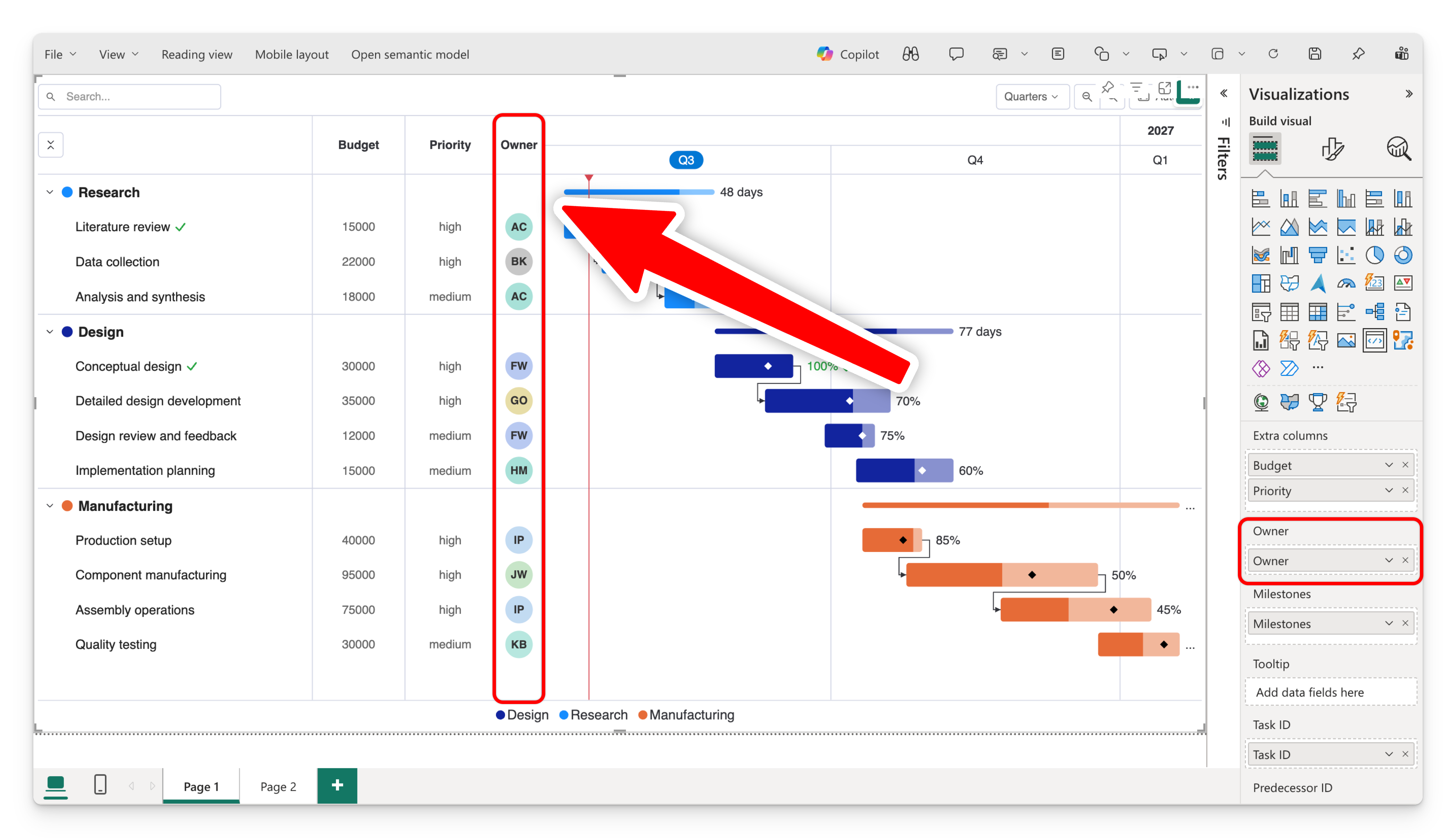

A few task rows with owner circles showing initials (e.g. "JS", "AB") in different colors

Task milestones

Optional · up to 5 columns · measures (dates)

One to five date columns, each plotted as a marker on the task's row. Use them for key dates such as kickoff, review, or go-live. Each milestone column can have its own marker symbol (circle, diamond, square, triangle, or star) and you can control marker size and whether markers outside a bar are hidden — see Milestones.

Tooltip

Optional · up to 4 columns · measures

Extra fields shown in the hover tooltip when someone points at a task bar, on top of the built-in details. Use it to surface context (owner, budget, notes) without cluttering the chart. The visual also supports Power BI report page tooltips.

URLs

Optional · up to 3 columns · measures

Up to three columns of web addresses, turned into links on the task. A task with at least one link shows a link icon in the task list; clicking it opens the address. With two or three links, the icon opens a small menu instead, and each entry is labelled with its column name — so name your columns for what they point at (Specification, Ticket, Dashboard).

TaskSpecificationTicket
Designhttps://contoso.sharepoint.com/design-spechttps://contoso.atlassian.net/browse/AB-42

A few things to know:

  • Links are leaf-only. Summary and project rows don't show the icon — only the tasks at the bottom of the hierarchy do.
  • Only http and https addresses work. Anything else — a relative path, a file: path, a blank value, or an address over 2,048 characters — is ignored, and the task simply shows no icon.
  • Keyboard users open the links with (right arrow) on a task row. See Keyboard navigation.

There's no Format pane setting for this — binding the field is the on/off switch.

Task ID & Predecessor ID

Optional · 1 column each · measures · required for dependency arrows

These two fields work together to draw dependency arrows between tasks:

  • Task ID — a unique identifier for each task (e.g. 1, 2, A10).
  • Predecessor ID — the ID(s) of the task(s) a given task depends on. Multiple predecessors are separated by commas or semicolons (e.g. 1,2 or 3;4).
Task IDTaskPredecessor ID
1Discovery
2Design1
3Build2
4Launch3

Full setup and styling is covered in Dependencies.

tip

Task IDs must be unique. If two tasks share an ID, the arrows can't resolve which task a predecessor refers to.


How much data the visual can show

The Gantt Chart loads large datasets in segments of 30,000 rows, up to a total of 90,000 rows. While the segments are arriving you'll see a "Loading tasks…" notice with a running row count.

If your data goes past 90,000 rows, the chart renders what it loaded and shows a dismissible notice reading "Showing the first N rows — the dataset is too large to load completely." The chart is still accurate for the rows it has, but it isn't the whole picture — filter the data down, or raise the level of the hierarchy, so the visual receives less.

tip

Rows here means rows delivered to the visual, not tasks on screen. Filtering the report, or summarizing at a higher level of the hierarchy, is almost always faster and easier to read than plotting tens of thousands of bars.

Next steps
